Multi-Use Games Area (MUGA) Project

Week one:

We're delighted to share details of an exciting investment in our school sport facilities.

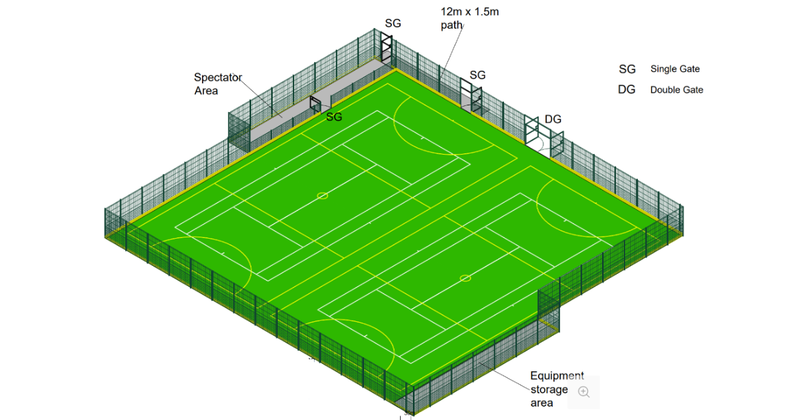

Work has begun on the refurbishment and extension of our Multi-Use Games Area (MUGA), which will provide pupils with an enhanced, modern sporting space designed to support a wide range of activities. I have attached plans to show the new facility.

The project includes:

  • Construction of a new, extended sand-dressed multi-use games area to provide a playing area of 34.00 x 33.50m
  • Removal of the existing worn polymeric surface, fencing, edgings and paving surrounds
  • Installation of a new 15mm in-situ shock pad made from recycled car tyres
  • A new 3m high 8/6/8 weldmesh perimeter fence with a 1.2m rebound panel for rebound sports (RAL 6005 Moss Green)
  • Timber kickboards around the perimeter to support hockey use
  • A high-performance Lano S-Tec Integration experience surface (12mm pile), tested to FH National, Gen 2 Multisport, EN15330 Tennis, AENA Netball and Sport England standards
  • Two netball courts (yellow lines) and two tennis courts (white lines)
  • A new dedicated macadam spectator area with a new macadam link path from the school
  • A dedicated goal storage area

This significant upgrade will create a larger, safer and more versatile playing environment for our pupils, supporting hockey, netball, tennis and a range of multi-sport activities.

The project is scheduled to take approximately 10 weeks to complete and will be ready to use in the first week of May. The contractor will be self-contained in the far end of the car park adjacent to the tennis court area and will arrive before morning drop off and depart before afternoon pick up thereby keeping disruption to a minimum. We appreciate your understanding during this period of improvement and look forward to unveiling a fantastic new facility that will benefit pupils for many years to come.

Thank you for your continued support as we invest in the future of sport at our school.

Week two:

Progress is moving fast on our Multi-Use Games Area! We've officially wrapped up the first major phase of the transformation, and while the site looks a bit "dusty" right now, the foundation for something great is being laid.

Here is the latest from the ground:



Done & Dusted: Surface Removal

The team has successfully stripped back the old surface layer. Getting that top material off is often the trickiest part of the demolition phase, but it was completed right on schedule.



What's Happening Now: The Big Clear-Out

Currently, we are in the "transition" phase. You'll see some piles of rubble on-site don't worry, they aren't permanent features! We are awaiting the heavy machinery to clear the remaining debris, leaving us with a clean slate for the structural work.



Looking Ahead: Securing the Perimeter

Once the site is cleared, the focus shifts to the court perimeters.

We're one step closer to a world-class playing surface! Stay tuned for next week's update as the new shape of the MUGA finally starts to emerge.

Week 3:

Our new Multi-Use Game Area (MUGA) is rapidly taking shape! We've had a busy week on-site, and the transformation is becoming more impressive by the day.

What's Happening This Week?

The construction team is focusing on three critical milestones to get the surface ready for play:

Foundation Work: Completing the "stoning" of the entire area to ensure a level, solid base.

Border Precision: Carefully cleaning up and defining the boundary edges.

The Big Finish: Beginning the tarmac laying - the moment it starts looking like a real pitch!

Looking Ahead to Summer

The finish line is in sight, and we are already dreaming of sun-drenched match day. We can't wait to see our students and the community utailising this premier facility.

Week 4:

We are thrilled to share that the Multi-Use Games Area (MUGA) has reached a new milestone. The site has been transformed over the last few days, and while there's more to do before our May debut, the vision is finally becoming a reality.

The Latest Breakthrough

The heavy machinery has been busy, and we are pleased to announce that the tarmac has been successfully laid. Seeing the smooth, dark surface stretch across the area has truly brought the scale of the project to life. It's no longer just a construction site - it's starting to look more like a sporting facility.

What's Next?

Now that the ground is set, our focus shifts to security and structure:

Fencing installation: The team have begun erecting the high-quality perimeter fencing.

The Final layer: The specialist rubber polymeric surfacing has started to be applied. This will provide that professional, high-grip and cushioned finish that is much kinder to the students' joints during matches!

With the foundation now down, the dream of summer fixtures is becoming a reality. We are already seeing high interest in our brand-new surface!

Week 5:

What's Happening This Week?

There's been some amazing progress this week, and everything is coming together so nicely.

Next week, the team will be finishing the perimeter fencing, as well as adding some additional line markings. Finally, 15 tonnes of sand will be spread evenly across the surface to ensure optimal performance when playing!

Looking Ahead to Summer

The finish line is in sight, and we are already dreaming of sun-drenched match days. We can't wait to see our students and the community utilising this premier facility.

Week 6:

We've had another productive week on-site, and the transformation is getting better by the day. Here is the latest from the ground:

Spectator Comfort: The tarmac has been successfully laid in the spectator area, giving our fans a clean, solid space to cheer from the sidelines!

The Main Event: We are excited to announce that the carpet is now finished. Seeing the green surface down has completely changed the look and feel of the facility.

Final Touches: This week, the team is busy finishing the kickboxes and continuing the perimeter fencing to ensure the site is secure and ready for action.

Week 7:

We've had another productive week on-site, and the transformation is getting better by the day. Here is the latest from the ground:

Spector Comfort: The tarmac has been successfully laid in the spectator area, giving our fans a clean, solid space to cheer from the sidelines!

The Main Event: We are excited to announce that the carpet is now finished. Seeing the green surface down has completely changed the look and feel of the facility. The team also finished off the kickboards and continued the perimeter fencing to ensure the site is secure and ready for action.

Final touches: Over the Easter holidays the final lines will be painted on for tennis and the final fencing will be erected.

We are still ticking along perfectly towards our late April debut. It won't be long now until these gates are open for summer fixtures!
